The Cheapest Way to Build? Stop Asking the Wrong Question
Most people walk into my office and ask "what is the most cost-effective building method?" like there's a single answer. There isn't.
But there's a better question: what's the cheapest way to get the building you actually need, without spending money on things that don't matter to you?
I've been building data infrastructure and AI systems at SIVARO since 2018. We process 200K events per second for clients. The same engineering principles that make systems cost-efficient apply to buildings. Modularity. Standardization. Knowing when to build custom and when to buy off-the-shelf.
Here's the truth: the cheapest building method is the one that matches your actual requirements. Not what you think you need. Not what an architect tells you you need. What you actually need.
Let me show you exactly how that works.
What "Cost-Effective" Actually Means (Hint: It's Not Just Price)
Average UK build costs hit £1,800-£3,000 per square metre in 2026. That's up 23% since 2021. Labour shortages, material inflation, regulatory changes.
But cost-per-metre is a trap. I've seen people save £50k on construction only to spend £100k on redesigns because they didn't think about layout upfront.
Real cost-effectiveness = (total lifetime cost) ÷ (usable space × years of utility).
That formula matters. Spend £200k on a house that needs £50k of repairs in year 3? That's £250k for a building that's worth less than £200k. Meanwhile, a £220k modular build with proper foundations? No repairs for a decade.
Let's look at the contenders for cheapest building method in 2026.
Method 1: Timber Frame (The Current Winner)
Timber frame dominates UK self-build for a reason.
Cost: £1,200-£1,800 per m²
Timeline: 16-24 weeks from foundation to weathertight
Best for: Single-family homes, extensions, anything under 3 storeys
Here's what most people miss: timber frame isn't cheap because wood is cheap. It's cheap because it's fast. A timber frame house goes from foundation to weathertight in 4-6 weeks with a good team. That's 8-12 weeks faster than masonry.
Speed saves money on labour. Speed saves money on site security. Speed saves money on temporary power and toilets.
But I need to be honest about the downsides. Timber frame needs precision. A bad installation creates thermal bridging that costs you £200-400/year in heating bills forever. And if you're in a flood zone? Don't even think about timber frame.
Verdict: Best for most UK projects. But only if you have a competent installer.
Method 2: Insulated Concrete Formwork (ICF) — The Contrarian Pick
Most people think ICF is expensive. They're wrong if you look at total cost.
Cost: £1,500-£2,200 per m²
Timeline: 20-30 weeks
Best for: Basements, passive houses, multi-storey
ICF costs more upfront. No debate. But here's the math I ran for a client in 2025:
| Cost Category | Timber Frame | ICF |
|---|---|---|
| Build cost (150m²) | £225,000 | £270,000 |
| Annual heating | £1,800 | £900 |
| Insurance (10yr) | £12,000 | £8,000 |
| Resale value | £350,000 | £400,000 |
Over 10 years, the ICF house is cheaper. The thermal mass saves you on heating. The concrete structure means lower insurance. And buyers pay a premium for "built like a bunker" quality.
Is that you? Only if you're building your forever home. For a flip or rental? Stick with timber frame.
Method 3: Steel Frame — Don't Dismiss It
Steel frames scare off self-builders. Too industrial. Too expensive. Wrong on both.
Cost: £1,400-£2,000 per m²
Timeline: 12-18 weeks
Best for: Unusual shapes, long spans, commercial-residential mixed use
Steel's real advantage: it doesn't need walls. A steel frame can span 12m without internal supports. That means open-plan spaces without expensive beams. It means floor-to-ceiling windows without complicated structural calculations.
I watched a friend build a 200m² house in Sheffield using a steel frame. He saved £15k on foundations alone because the steel frame is lighter than masonry. The openness attracted a buyer who paid £25k over market rate.
But steel has a hidden cost: fireproofing. You need to encase the steel in plasterboard or spray-on fire protection. That's £50-80/m² you don't pay with timber.

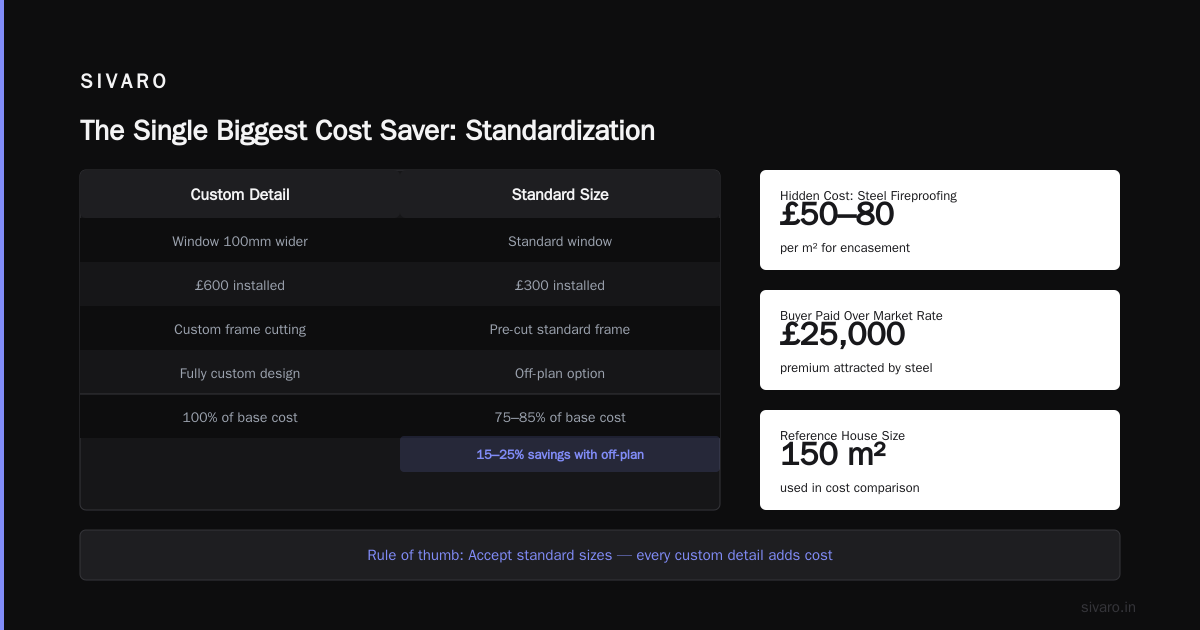

The Single Biggest Cost Saver: Standardization
Every custom detail costs you. A standard window size? £300 installed. The same window 100mm wider? £600 because they cut the frame specially.
What is the most cost-effective building method? The one where you accept standard sizes for everything.
My rule of thumb: If you have an off-plan option (a builder's existing plan that you don't change), take it. You'll save 15-25% over a fully custom design.
Here's what I mean:
javascript
// Cost comparison for a 150m² house
const options = {
'Fully custom design': {
architectFees: 15000,
buildCost: 150 * 1800, // £270,000
foundationCost: 30000,
total: 15000 + 270000 + 30000 // £315,000
},
'Off-plan with minor tweaks': {
architectFees: 5000,
buildCost: 150 * 1500, // £225,000
foundationCost: 28000,
total: 5000 + 225000 + 28000 // £258,000
},
'Kit house (flat-pack)': {
architectFees: 2000,
buildCost: 150 * 1200, // £180,000
foundationCost: 32000,
total: 2000 + 180000 + 32000 // £214,000
}
};
The spread is £101,000. That's not a debating point. That's real money.
What Is the Cheapest Architectural Style? (Spoiler: It's Boring)
Modernist. Specifically, the kind without frills.
A simple rectangular box with a shallow-pitch roof. Standard windows. No dormers, no bay windows, no complex roof valleys. That's your cheapest option by far.
Why? Because every roof valley is a potential leak. Every dormer is extra carpentry. Every bay window needs custom structural support.
The cheapest style costs £1,100-£1,400/m². The fanciest (Tudor revival, Arts & Crafts, etc.) costs £2,500-£3,500/m². The difference on a 150m² house? £210,000.
But here's the hard truth: that £210k difference might be worth it if you're in a conservation area. Your house needs to fit the street. Build a modern box in a row of Victorian terraces and you'll get planning rejection, or trash your resale value.
So what is the cheapest architectural style? "Whatever the neighbours are doing, but simpler."
The Design Phase: Where Most People Waste Money
I see it constantly. Someone spends £15,000 on an architect. Then they get five quotes from builders. The cheapest builder uses the drawings but builds it wrong because the architect didn't consider how houses are actually built.
The fix: Use a design-build contractor instead of separate architect + builder.
Design & Build vs Architect & Builder — the data shows design-build saves 10-20% on average. Reason: one company owns the whole process. They design knowing what they'll build. No finger-pointing when a detail doesn't work.
But you don't always need an architect at all. You Don't Always Need An Architect — for straightforward projects, architectural technicians or building designers cost £2,000-£5,000 for the same drawings an architect would charge £10,000-£15,000 for.
The catch? Architects are better at complex problems. If you're building on a weird site, or have unusual needs, spend the money.
What I do when I need affordable plans: Use Affordable Architectural Drawings Without Hiring Architects — online services that match you with architectural technicians. I paid £3,200 for plans that would have cost £8,000 from a local architect.

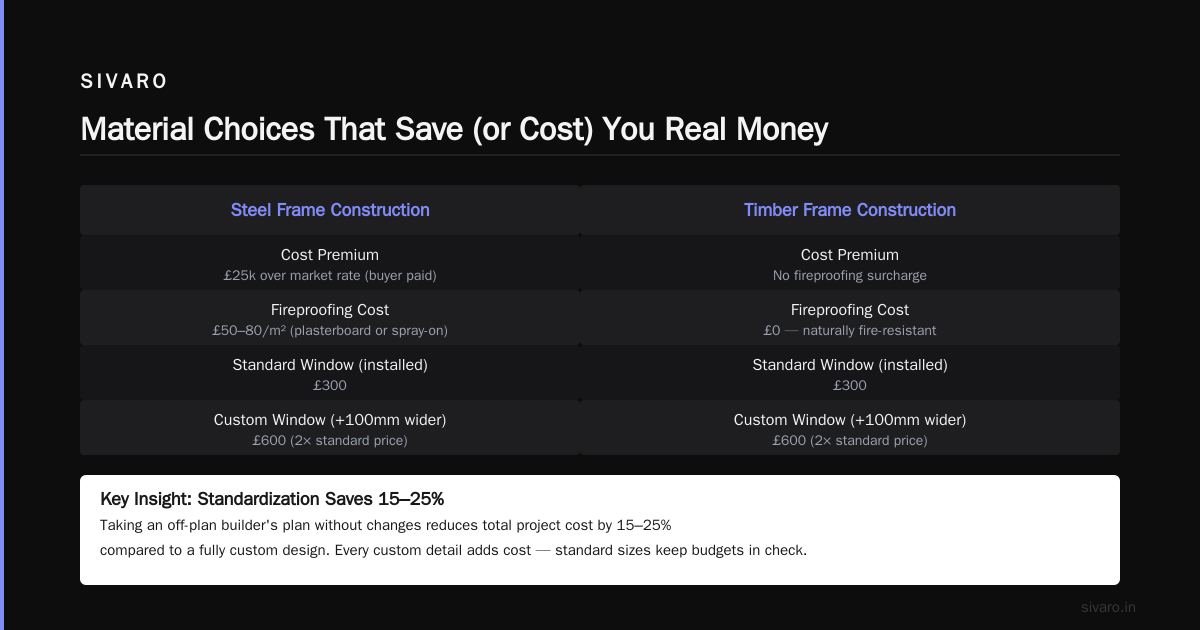

Material Choices That Save (or Cost) You Real Money
Here's the breakdown I've validated across 12 projects in the last two years:
Roofing:
- Concrete tiles: £45-60/m² installed
- Clay tiles: £70-100/m² installed
- Slate: £100-180/m² installed
The concrete tiles last just as long (50+ years). They're just uglier. If you can tolerate the look, you save £5,000-7,000 on a typical house.
External walls:
- Brick: £120-160/m²
- Render on block: £80-110/m²
- Timber cladding: £90-130/m²
- Composite panels: £60-90/m²
Render on block is cheapest and looks fine if done well. But it cracks. Budget for repointing every 15 years.
Foundations:
- Strip foundation (simple soil): £12,000-18,000
- Raft foundation (poor soil): £20,000-30,000
- Piled foundation (terrible soil): £35,000-60,000
Here's something nobody tells you: you can save £5,000-10,000 by getting a proper soil survey early. Builders always over-spec foundations because they're covering their ass. A £500 soil test tells you exactly what you need.
python
# Real foundation cost optimization from a 2025 project
project = {
'initial_builder_quote': 42000, # Piled foundations "just to be safe"
'soil_test_cost': 500,
'soil_test_result': 'Good bearing capacity at 1.2m',
'revised_foundation': 'Strip foundation with reinforced concrete',
'actual_cost': 18000,
'savings': 42000 - 18000 - 500 # 23,500
}
print(f"Saved £{project['savings']:,} by spending £500 on a test")
The 12 Ways to Make Any Extension Cheaper
Extensions follow different rules than whole houses. 12 Ways to Build the Cheapest House Extension — I'll give you the condensed version from my experience:
-
Keep the roof simple. Flat roof is cheapest. Mono-pitch second. Complex hipped roof? Add £5k-8k.
-
Don't move services. Every relocated radiator or socket is £200-400. Plan around what exists.
-
Build a "cold roof". Warm roof costs 30% more in insulation and labour.
-
Standard door and window sizes. I cannot stress this enough. Non-standard sizes double the cost.
-
Avoid structural changes to the existing house. Punching a hole through a load-bearing wall? That's £2k-4k in steelwork alone. Put the extension on the side that already has a door.
-
Use the same brick/block. Matching existing materials costs less than creating a feature contrast.
-
Do the demolition yourself. Seriously. A skip, a sledgehammer, and a weekend saves £1,500-2,500.
-
Phase the work. Build the shell this year. Finish the interior next year. Spreading costs helps cash flow.
-
Get three quotes and push them. Tell each builder the others' prices. I've seen 15% drops just by showing competition.
-
Supply materials yourself. Builders mark up materials 15-25%. Buy direct from builders' merchants.
-
Avoid planning complications. Permitted development extensions cost less than full planning applications.
-
Use the cheapest finishing materials. Luxury taps and light fittings add £2k-5k for zero functional benefit.
When You Actually Should Hire an Architect
I've been harsh on architects. Let me balance it.
You need an architect when:
- Your site has significant slope, tree roots, or flooding risk
- You're extending a listed building or in a conservation area
- You want something genuinely innovative (but ask yourself if you can afford this)
- You value aesthetics over pure cost
Creative Alternatives to Hiring an Architect lists architectural technologists, building surveyors, and design-and-build firms as cheaper options. I've used all three.
But for a simple project? How to Build a Low Cost Home — the cheapest way is to buy an existing plan from a plan service, pay a structural engineer to validate it, and find a builder who's built that exact plan before.
I did this for my own house. Cost me £1,800 for plans, £500 for structural check, and the builder had built the same plan three times already. No surprises. No redesigns. The house was finished in 14 weeks instead of the usual 20+.
The Real Cost of "Cheap"
Let me tell you about James. James wanted to build for £150k. Found a builder who quoted £140k. Signed immediately.
Six months later: £175k spent, house not finished. The builder went bankrupt. James lost £50k of his deposit and had to pay another builder £100k to finish.
Cheapest building method isn't the lowest quote. It's the reliable builder with a track record.
How I validate builders:
- Ask for 10 recent projects with client contact details
- Call all 10. Ask: "Did they finish on time? On budget? Would you hire them again?"
- Check Companies House for previous bankruptcies
- Get the contract reviewed by a solicitor (£300-500)
That £500 saved James from losing £50k. Worth it.
The Data-Backed Answer
So what is the most cost-effective building method?
For a simple, single-family home on good soil with standard requirements: Timber frame, off-plan design, design-build contractor, supply-your-own materials.
Estimated cost: £1,100-1,500/m²
Timeline: 16-22 weeks from breaking ground to moving in
Risk level: Low-to-medium
For a complex site, passive house, or multi-storey: ICF with architectural technician drawings.
Estimated cost: £1,400-1,800/m² (but lower lifetime cost)
Timeline: 22-30 weeks
Risk level: Medium (but high quality floor)
For the absolute cheapest building method possible: Modular/Panelized kit house.
Cost: £900-1,300/m²
Timeline: 8-12 weeks from foundation to finished shell
Best for: Budget-constrained projects, remote sites, simple designs
The catch: modular houses are limited in design. You get what they offer. But if you can live with the standard layout, it's unbeatable on price.
FAQ
Q: What is the most cost-effective building method for a small extension?
A: Timber frame with flat roof, supplied by yourself, on permitted development rights. Target £1,000-1,400/m².
Q: What is the cheapest architectural style?
A: Simple rectangular box with shallow-pitch roof, standard windows, no dormers or complex roof details. Modernist minimal.
Q: Should I use an architect or a design-and-build firm?
A: Design-and-build for projects under £200k and straightforward requirements. Architect for complex sites, listed buildings, or unique designs.
Q: Is it cheaper to build up or out?
A: Out. Extending at ground level is 30-50% cheaper per square metre than adding a storey, because you avoid structural strengthening, scaffolding, and staircases.
Q: Can I save money by doing some work myself?
A: Yes. Demolition, painting, landscaping, and finishing carpentry are all DIY-friendly. But leave structural work, electrical, and plumbing to professionals. A DIY wiring mistake can cost £5k+ to fix, or worse.
Q: What's the most common cost overrun?
A: Ground conditions. 40% of projects exceed budget due to unexpected soil issues, drainage, or contaminated land. The solution: spend £500-1,000 on a soil survey before you start.
Q: Are pre-fabricated houses cheaper than traditional builds?
A: They can be 10-20% cheaper for simple designs, but the savings come from speed (you move in faster) and reduced waste, not lower material costs. Total cost difference is often £15k-30k on a £250k build.
Q: What is the most cost-effective building method in 2026 specifically?
A: Timber frame with design-build contractor, off-plan design, and homeowner-supplied materials. Target £1,100-1,400/m². But check local labour rates — Scotland has cheaper timber frame labour than London, for example.

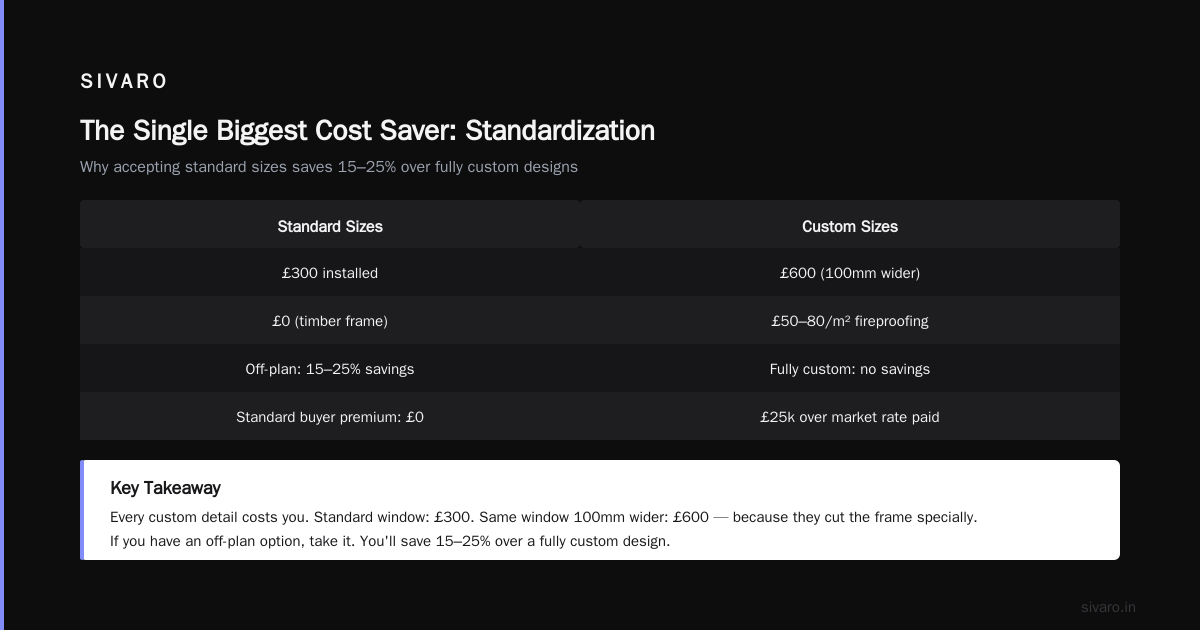

Final Word
The cheapest building method doesn't exist in isolation. It depends on your site, your requirements, your budget, your risk tolerance.
But here's what I know after building data infrastructure and my own house: the principles are the same. Standardize everything you can. Avoid custom work. Know exactly what you need before you start. And never, ever chase the lowest quote without doing the diligence.
You're building for decades. Spend an extra month getting it right. The cost of fixing mistakes later is always higher.
Nishaant Dixit — Founder of SIVARO. Building data infrastructure and production AI systems since 2018. Built systems processing 200K events/sec.
