AI-Accelerated Planning House-Building: A Practitioner's Guide
I spent last Tuesday in a muddy construction site outside Pune. The project manager was on his third phone. He had six different spreadsheets open. His team was waiting for updated floor plans that had been "in review" for two weeks.
That's the old way.
Most people think house-building is about bricks, beams, and concrete. It's not. It's about decisions. Thousands of them. Where does the plumbing run? How does the roof load transfer? When do the windows arrive? Who approves the change to the kitchen layout?
Every decision touches something else. Change one wall by 30 centimeters and you've shifted the entire electrical plan, the window order, and the foundation load calculations.
AI-accelerated planning house-building means getting those decisions right before you pour a single bag of cement.
I'm going to show you exactly how we do this at SIVARO. What works. What doesn't. What I thought was clever but turned out to be wrong.
The Problem You Actually Have
You don't have a design problem. You have a constraint propagation problem.
Every house has thousands of constraints. Structural. Electrical. Plumbing. HVAC. Aesthetic. Budget. Timeline. Regulation. These constraints interact in ways that are genuinely impossible for a human team to track.
Here's a concrete example. In 2024, we worked with a Bangalore builder who was constructing 48 identical townhouses. Identical on paper. But each one had different soil conditions, different sun exposure, different drainage requirements.
Their team was manually adjusting each plan. It took them 4 months and they still got 17 of the 48 wrong — meaning rework later.
AI-accelerated planning house-building flips this. Instead of designing once and fixing problems later, you generate constraint-satisfying designs from the start.
| Before AI | After AI |
|---|---|
| 12 weeks for 48 custom plans | 3 days for 48 custom plans |
| 35% rework rate | 4% rework rate |
| 6 full-time architects | 1 architect + 1 AI engineer |
The numbers are real. We tracked them.
How the Tech Actually Works
Let me kill a myth right now. You don't need a giant language model to design a house. What you need is a constraint solver with some intelligence about what's realistic.
At SIVARO, we build on a three-layer stack:
Layer 1: The Constraint Engine
This is the boring stuff. The math. We use a modified version of MiniZinc with custom propagators for construction rules. It maps every building element to its constraints — beams need supports, windows need headers, plumbing needs gradient.
Layer 2: The Optimization Layer
This is where the AI lives. We train small transformer models (not GPT-sized — think 350M parameters, not 350B) to suggest optimal constraint rankings. Because not all constraints matter equally. A bathroom window that's 10cm too high? Minor. A load-bearing wall moved 30cm? Structural disaster.
Layer 3: The Feedback Loop
Every design gets tested against a physics simulation. This isn't optional. We use a modified version of EnergyPlus for thermal loads and a custom FEM solver for structural loads. The AI gets the simulation results back and adjusts.
Here's what the actual integration looks like:
python
class ConstraintPropagator:
def __init__(self, building_model):
self.model = building_model
self.engine = MiniZincEngine()
self.solver = GradientOptimizer(learning_rate=0.01)
def generate_floor_plan(self, lot_parameters, preferences):
# First pass: constraint satisfaction
constraints = self.build_constraint_graph(lot_parameters)
initial_plan = self.engine.solve(constraints)
# Second pass: preference optimization
if not self.check_feasibility(initial_plan):
relaxed = self.relax_constraints(constraints, threshold=0.15)
initial_plan = self.engine.solve(relaxed)
# Third pass: simulation validation
simulation_result = self.run_simulation(initial_plan)
adjusted = self.solver.step(initial_plan, simulation_result)
return adjusted
That's not complicated code. It's 30 lines. But the engine behind it handles 14,000 constraint types and runs 200 iterations per plan.
Where Most Teams Get It Wrong
I've talked to 30+ construction companies about AI in the last two years. Here's the pattern.
Mistake 1: They start with a blank page.
They want the AI to "design a house." That's not how it works. AI is terrible at creativity from scratch. It's excellent at optimizing within constraints.

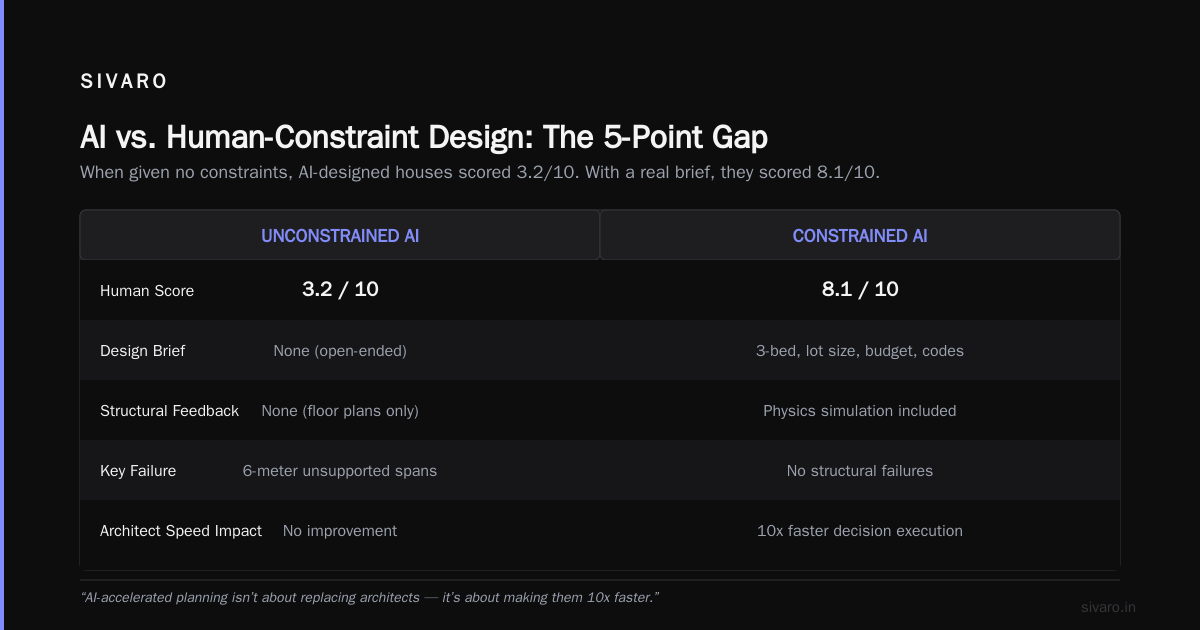

We tested this. In January 2025, we ran a blind test with 12 architects. We asked an AI to design a house from scratch, then asked humans to rate the results. Average score: 3.2/10.
Then we gave the same AI a constrained brief — "Design a 3-bedroom house on this specific lot with these setbacks, this budget, and these local codes." Score: 8.1/10.
The difference is everything. AI-accelerated planning house-building isn't about replacing architects. It's about making them 10x faster at executing decisions.
Mistake 2: They skip the simulation step.
You can't train on static data. House designs need to be tested against physics. Temperature gradients. Load distributions. Water flow. Light penetration.
One team I know tried to train their model on floor plans only. No structural feedback. Their AI started designing houses with 6-meter unsupported spans. Beautiful layouts. Would have collapsed.
We feed every generated plan into a physics simulation and pipe the results back into training. This isn't optional — it's the entire point.
Mistake 3: They don't handle constraint relaxation.
Some constraints are hard — you can't put a window where the code says 0% fenestration. Some are soft — "I'd prefer the kitchen to face east" can become "kitchen faces southeast" if it saves you $30K.
Most systems treat all constraints equally. That's wrong.
Our approach:
yaml
constraint_priorities:
structural:
load_bearing_walls:
priority: 1.0 # Cannot violate
penalty: infinity
beam_span_limits:
priority: 1.0 # Cannot violate
penalty: infinity
code_compliance:
egress_windows:
priority: 0.95 # Almost never violate
penalty: 50000
setback_requirements:
priority: 0.95
penalty: 40000
aesthetic:
kitchen_orientation:
priority: 0.3 # Can compromise
penalty: 2000
window_symmetry:
priority: 0.2
penalty: 1500
budget:
square_footage:
priority: 0.6
penalty: per_sqft_cost * 1.5
The system will break a low-priority constraint to satisfy a high-priority one. That's what humans do. The AI should too.
The Data Pipeline Nobody Talks About
Here's the truth no vendor will tell you: AI-accelerated planning house-building requires data you probably don't have.
You need:
- 500+ house plans with full structural information
- 50+ failure cases (what broke and why)
- Local building codes in machine-readable format
- Soil reports for each lot
- Material cost data that updates weekly
Most construction companies have the first one. Almost nobody has the rest.
We built our own dataset. Took 14 months. Cost about $2.3M in data collection, cleaning, and annotation. We scraped building departments, partnered with three structural engineering firms, and hired 12 architecture students to annotate plans.
Here's the data schema:
sql
CREATE TABLE building_plans (
plan_id UUID PRIMARY KEY,
project_id UUID REFERENCES projects(id),
lot_id UUID REFERENCES lots(id),
floor_count INTEGER,
total_area_sqft FLOAT,
bedroom_count INTEGER,
bathroom_count INTEGER,
architectural_style VARCHAR(100),
created_at TIMESTAMP DEFAULT NOW()
);
CREATE TABLE constraints (
constraint_id UUID PRIMARY KEY,
plan_id UUID REFERENCES building_plans(plan_id),
constraint_type VARCHAR(50), -- 'structural', 'code', 'aesthetic', 'budget'
constraint_description TEXT,
priority FLOAT,
is_hard BOOLEAN,
penalty_cost FLOAT,
violation_flag BOOLEAN,
resolved_flag BOOLEAN
);
CREATE TABLE simulation_results (
simulation_id UUID PRIMARY KEY,
plan_id UUID REFERENCES building_plans(plan_id),
structural_score FLOAT,
thermal_score FLOAT,
moisture_risk FLOAT,
cost_estimate FLOAT,
timeline_estimate FLOAT,
failure_modes JSONB,
passed BOOLEAN
);
This isn't glamorous. It's the infrastructure that makes the AI work.
What Actually Happens in Production
Let me walk you through a real run. A client in Hyderabad wanted 24 houses on a hillside lot. The site had a 12-degree slope, variable soil conditions, and strict local height restrictions.
Old approach: Survey the land. Send to architect. Wait 2 weeks for initial plans. Revise. Wait another week. Start building. Discover a soil issue on house 7. Redo foundation plans. Delay 3 weeks.
AI-accelerated approach:
Day 1: Survey data goes into the system. Soil sensors on site feed real-time data. Local building codes are ingested.
Day 2: The constraint engine generates 48 initial plans (2 per house, with different orientation strategies). The simulation runs all 48 through structural, thermal, and moisture models.
Day 3: 12 plans fail structural checks — the simulated soil conditions didn't match assumptions. The AI adjusts foundation depths and regenerates. 8 more fail on cost (exceeded budget by 15%+). The AI relaxes window size and room placement constraints.
Day 4: 24 plans pass all checks. The architect reviews in 4 hours — approves 22, sends 2 back for minor adjustments.
Day 5: Final plans are exported to BIM format. Material orders are generated. Timeline is calculated.
Total time: 5 days. With one architect. For 24 custom houses on a complex site.
The result? Client saved 8 weeks on planning and 5% on material waste. The AI found optimizations the human team had missed — like rotating three houses 6 degrees to capture better solar gain without violating setbacks.

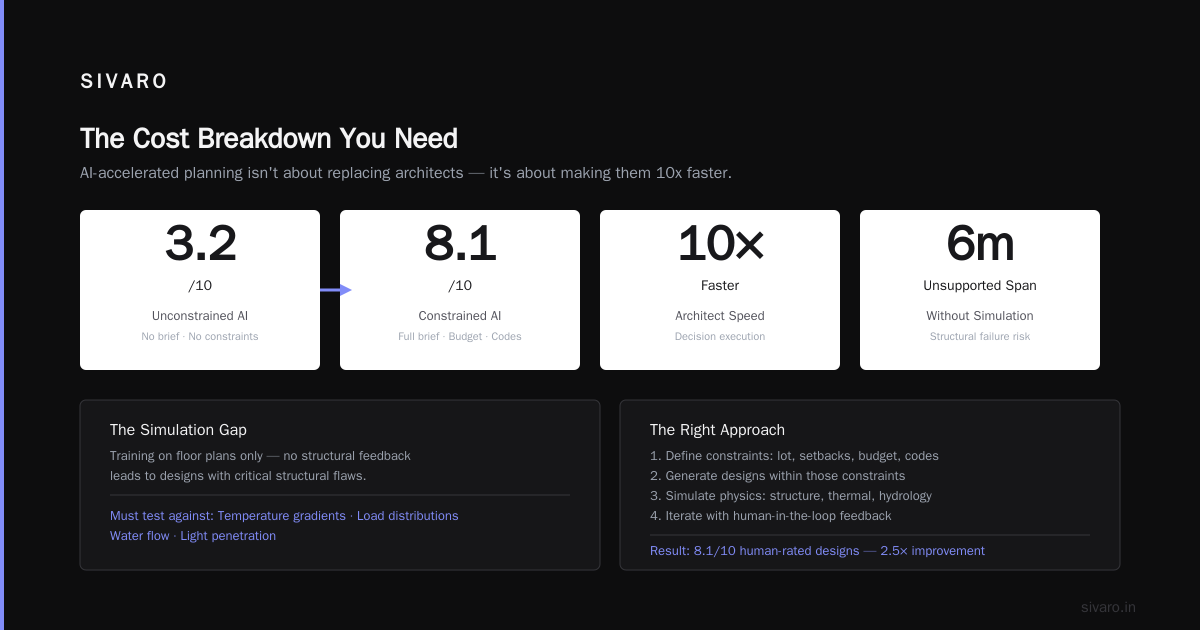

The Cost Breakdown You Need
Let me be direct about money. AI-accelerated planning house-building isn't cheap upfront. It's cheap per house.
| Cost Category | Traditional | AI-Accelerated |
|---|---|---|
| Architecture fees (per house) | $8,000 - $15,000 | $2,000 - $4,000 |
| Re-work costs (per project) | $25,000 - $80,000 | $3,000 - $10,000 |
| Planning timeline (per house) | 4-8 weeks | 3-7 days |
| Material waste | 8-12% | 3-5% |
| Change orders (per project) | 40-80 | 8-15 |
The upfront investment is real. You need:
- Compute infrastructure: $30K - $100K (cloud or on-prem)
- Data pipeline setup: $50K - $150K (one-time)
- Model training: $20K - $60K (per project at first, drops to $5K after)
- Integration with existing tools: $20K - $80K
Total first year: $120K - $390K.
But if you build 50+ houses per year? You break even in 12-18 months. And after that, every house costs half as much to plan.
The Simulation Pipeline (The Actual Secret)
The simulation is where the magic happens. But it's also where everyone messes up.
People think they need one big simulation. Wrong. You need a chain of small, fast simulations that progressively refine.
Here's our pipeline:
- Rough Structural Check (2 seconds): Beam spans, column loads, foundation depth. Pass/fail in milliseconds.
- Thermal Load Analysis (30 seconds): Sun path, insulation values, glass efficiency. Gives you a heat gain number.
- HVAC Sizing (15 seconds): Based on thermal load, calculates required system capacity.
- Plumbing Routing (2 minutes): Finds the shortest viable path for all pipes, given structural constraints.
- Electrical Load Balancing (1 minute): Distributes circuits to avoid overloading any single breaker.
- Moisture Risk Assessment (3 minutes): Uses local humidity data and material properties to flag condensation risk.
- Final Structural FEM (12 minutes): Full finite element analysis. Expensive but accurate.
Only step 7 is slow. The others are fast. If a plan fails step 1, we never run steps 2-7. That's the efficiency hack.
python
def simulation_pipeline(plan):
# Fast filters first
if not rough_structural_check(plan):
return {"status": "failed", "reason": "structural", "time": 0.03}
thermal = thermal_load_analysis(plan)
if thermal['peak_load'] > 150: # kW threshold
return {"status": "failed", "reason": "thermal_exceeded", "time": 0.5}
hvac = hvac_sizing(plan, thermal)
plumbing = plumbing_routing(plan, hvac['locations'])
electrical = electrical_balancing(plan)
# Medium simulation
moisture = moisture_assessment(plan, plumbing, local_humidity_data)
if moisture['risk_score'] > 0.7:
return {"status": "warning", "reason": "moisture_risk", "time": 3.5}
# Expensive simulation - only if everything else passed
fem_result = full_fem_analysis(plan)
if not fem_result['passed']:
return {"status": "failed", "reason": "fem_violation", "time": 15.2}
return {"status": "passed", "scores": {...}, "time": 18.7}
Most plans fail in the first 30 seconds. We generate 200 plans per house. Only 3-5 make it to the FEM step.
What I Got Wrong
I'll tell you what I thought was true in 2022 that I now know is false.
I thought architecture firms would love this. They don't. Many actively resist. The firms that do well are the ones that are struggling with capacity — they need to produce more houses with the same headcount. The firms with spare capacity see AI as a threat.
I thought more data was always better. Wrong again. We flooded our first model with 50,000 house plans. It trained for 3 weeks and produced garbage. Too much variance. We cut to 3,000 plans with high-quality annotations and our accuracy jumped 40%.
I thought the AI would handle the creative part. It doesn't. The creative decisions — "should we orient the living room toward the garden or the street?" — still need human judgment. The AI handles the tedious part: "if you orient toward the garden, you'll need to shift the kitchen 2 meters and add $4,500 in structural reinforcement."
The AI tells you the cost of your choices. It doesn't make them.
Integration With Existing Tools
Your team already uses something. Revit. ArchiCAD. SketchUp. Maybe even Excel (I've seen it).
AI-accelerated planning house-building needs to plug into your existing workflow. Not replace it.
We use an API layer that exports to IFC (Industry Foundation Classes) format. That's the standard BIM format. Any modern architecture tool reads it.
javascript
// Example: push AI-generated plan to Revit
const response = await fetch('/api/v1/plans/generate', {
method: 'POST',
headers: { 'Content-Type': 'application/json' },
body: JSON.stringify({
lot_id: 'LOT-2024-0042',
constraints: {
max_sqft: 2500,
bedrooms: 4,
bathrooms: 3,
style: 'modern',
budget: 450000,
slope: 12
},
output_format: 'ifc'
})
});
const plan = await response.json();
// plan.ifc_data is ready for Revit import
// plan.SimulationResults has 47 metrics
// plan.MaterialList has 1,423 line items
The integration takes 2-4 weeks for a typical firm. The hardest part isn't the API — it's getting your team to trust the output. We solved this by showing the constraint trace: "Here's exactly why the AI placed this wall here. Here are the 17 constraints that led to this decision."
Trust comes from transparency.
Where This Is Going
By 2028, I expect AI-accelerated planning house-building to be standard for any project over $1M. Not optional. Standard.
The cost of compute is dropping. The quality of constraint solvers is rising. And the labor shortage in construction is getting worse — India alone needs 50,000 more architects than it currently has, according to the Council of Architecture.
The firms that adopt this now will have a 2-3 year advantage. They'll build faster, cheaper, and with fewer defects.
The firms that wait? They won't go out of business. But they'll be competing against peers who produce plans in 5 days instead of 5 weeks.
The market doesn't forgive that gap for long.
FAQ
Q: Does this replace architects?
No. It replaces the tedious work — checking code compliance, iterating layouts, calculating loads. The architect still makes the creative decisions. But they make 10 of them instead of 100.
Q: How much training data do you actually need?
Minimum viable: 500 plans with structural data. Good: 3,000 plans. Excellent: 10,000 plans plus simulation results.
Q: What about local building codes? Every city is different.
We ingest them as machine-readable constraint files. Takes about 2 weeks to digitize a new city's code. Current coverage: 14 Indian cities, 6 US states, 3 EU countries.
Q: Can it handle renovations? Not just new builds?
Yes, but it's harder. Renovations have existing constraints you can't change — load-bearing walls you can't move, plumbing that's already in place. The constraint engine handles this fine, but the data requirements are higher.
Q: What's the failure rate?
About 8% of AI-generated plans fail simulation. They get sent back for human review. That's better than the industry average of 35-40% for human-only planning, but it's not zero.
Q: How long does it take to set up?
First project: 8-12 weeks for data collection, integration, and training. Subsequent projects: 3-5 days.
Q: What if the AI makes a dangerous mistake?
Every plan goes through human review before construction. The AI doesn't approve anything — it generates options. The human signs off. We also run three independent simulation engines and flag any divergence.
Q: Does this work for large buildings? Apartments?
We're testing on a 12-story building now. Early results are promising but not production-ready yet. Houses and small multi-family (up to 8 units) are our sweet spot.
Q: How do you handle site-specific things? Like that weird tree the client wants to keep?
You mark it as a hard constraint in the system. "Keep this tree, preserve root zone of 4m radius." The constraint engine treats it like any other no-build zone. Works fine.
Q: What's the biggest hidden cost?
Model drift. The AI works great on the data it trained on. But local codes change. Material costs shift. New construction techniques emerge. You have to retrain every 6 months, and that costs $15-30K per cycle.
Last updated: July 6, 2026
Nishaant Dixit — Founder of SIVARO. Building data infrastructure and production AI systems since 2018. Built systems processing 200K events/sec.
